Skip to main content
Skip table of contents

Use sprint start/end dates to automatically show issues on the calendar

ActivityTimeline Integration with Sprints

For those who work in sprints, ActivityTimeline allows the re-use of the Start/End dates of the whole sprint for individual stories/tasks of the sprint. This feature simplifies the process of managing tasks within a sprint by automatically populating users’ timelines based on the sprint schedule.

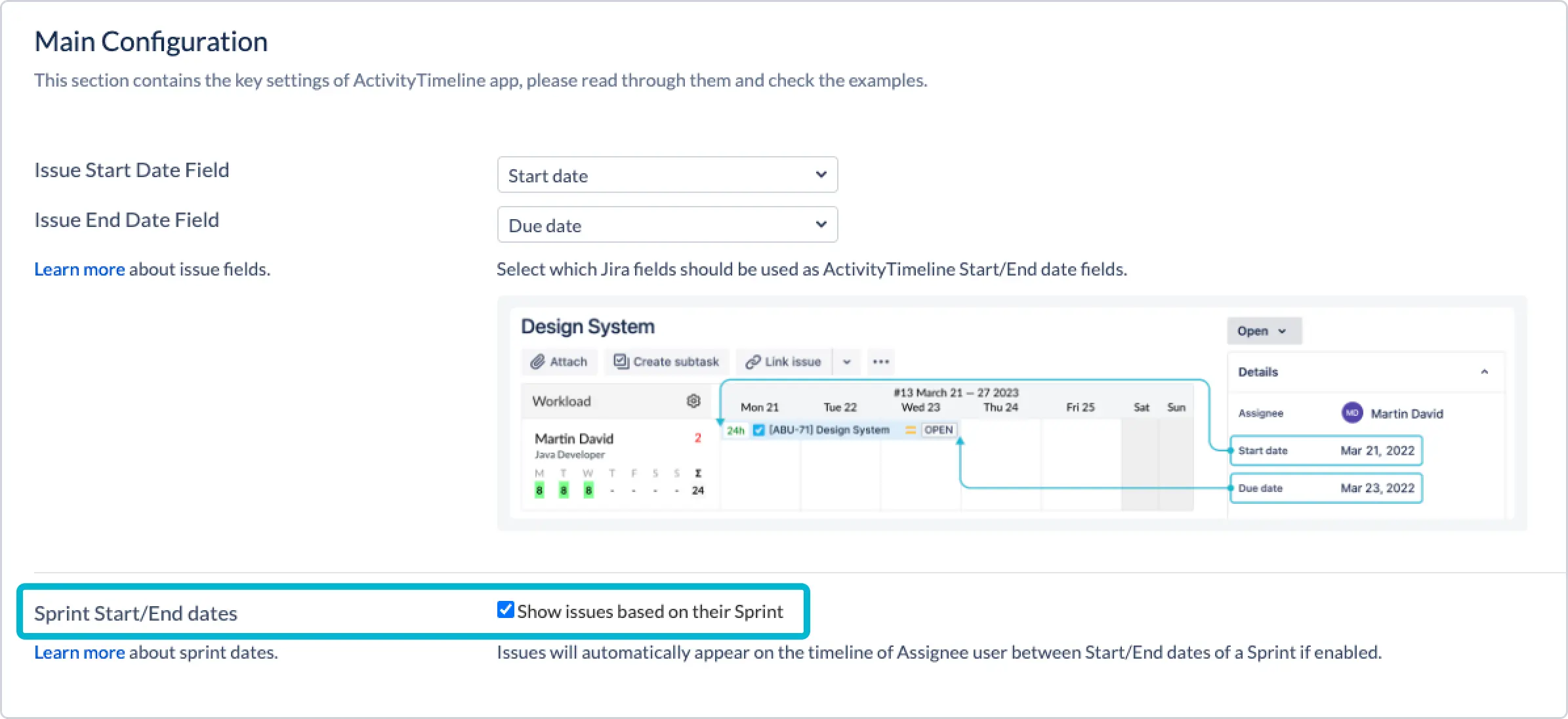

You need to have a Sprint that already has its Start/End dates defined and tasks assigned to users in Jira and ActivityTimeline you need to enable the option to “Show issues based on their Sprint” (Once enabled, please, navigate to Configuration → Synchronization → Refresh Issues → Perform Full Issues Refresh'):


After you do this, the system will automatically display tasks on the timelines of your users, based on the Sprint Start/End dates.

Priority of Issue Start/End Date Fields in ActivityTimeline: To display issues on the timeline based on sprint dates, please ensure that the Issue Start/End Dates are either empty in Jira or not mapped in ActivityTimeline.

Assignments of Tasks to Sprints

Assignments of tasks to sprints can be managed directly within Jira or from ActivityTimeline.

From Jira:

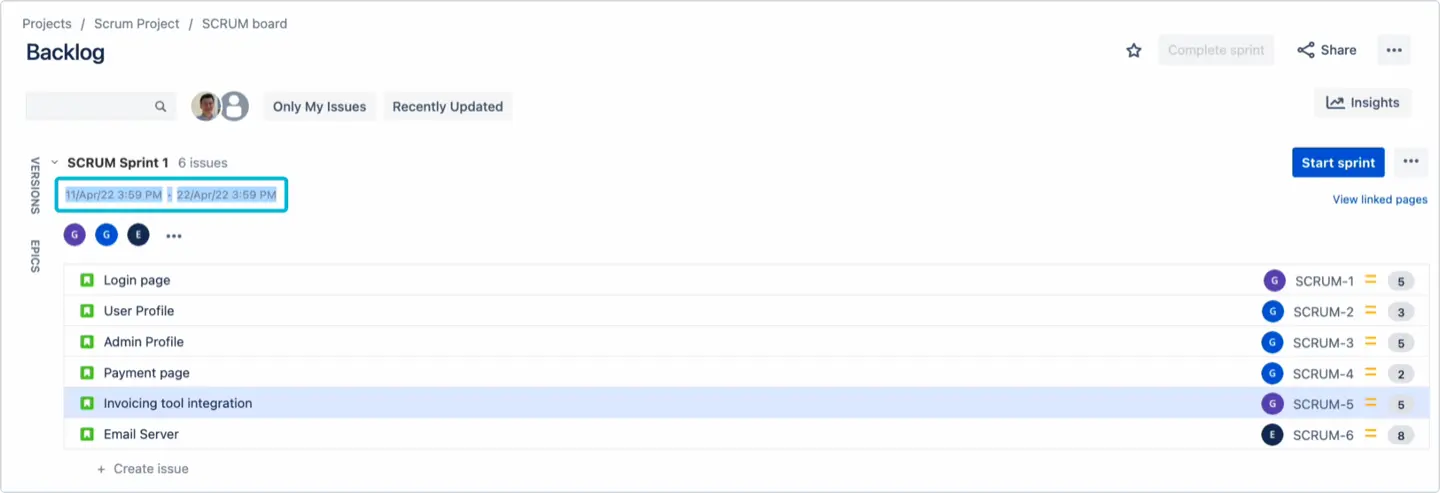

During the sprint planning phase, teams decide which tasks (issues) from the project backlog will be worked on during the upcoming sprint. These tasks are then moved to the sprint backlog.

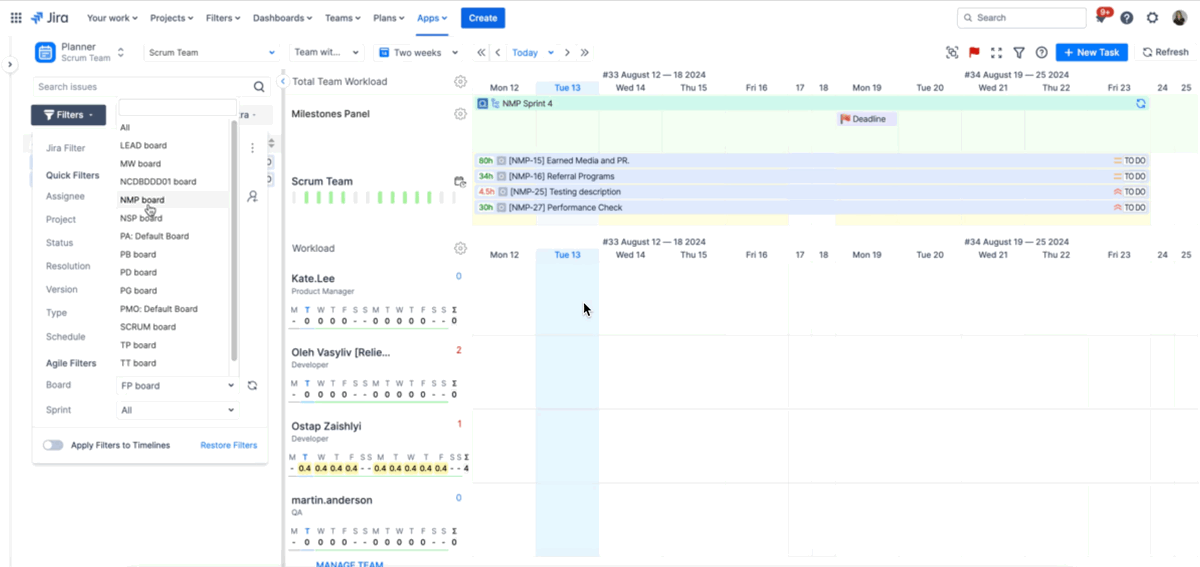

A short video below demonstrates best practices for sprint planning combining Jira and ActivityTimeline functionality:

  1. Create a Sprint in Jira and add tasks to it.

  2. If you want to preplan on the team level first, add a team to the tasks (ActivityTimeline team field) or assign it directly to users.

  3. Navigate to ActivityTimeline → Click ‘Refresh’ to synchronize changes

  4. Assign team members to tasks based on their availability from the Team Panel

From ActivityTimeline:

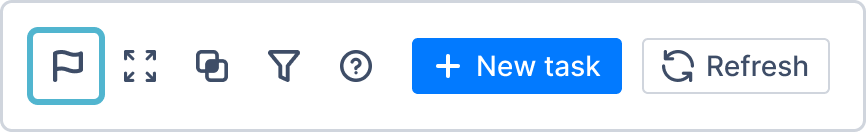

Sprints can be visualized in ActivityTimeline using a Milestone panel. By default, the Milestones Panel is hidden from the dashboard. To open it, click on a flag icon on the right panel toolbar.


Click on the ⚙️ icon to choose the projects Projects and Boards to display. Sprint will be shown for its whole duration (Based on its Start and End date). By clicking on the hierarchy icon, you will be able to see all tasks inside the sprint and their statuses.

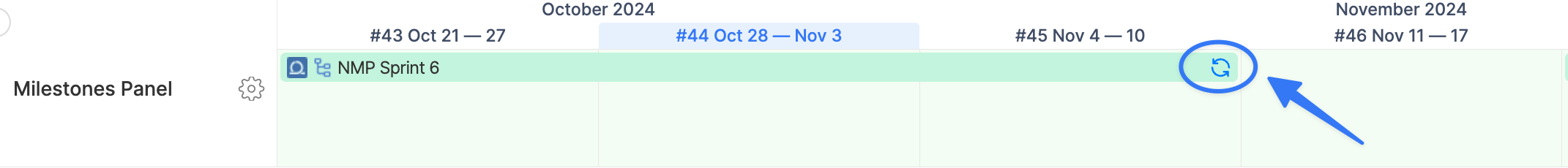

Dragging a task from the left panel or timeline to the sprint line on the Milestone panel will update the sprint value in Jira:

Sprints Dates and Date Fields

By default, Issue Start/End Date Fields in ActivityTimeline have higher priority than sprint dates. To display issues on the timeline based on sprint dates, please ensure that the Issue Start/End Dates are either empty in Jira or not mapped in ActivityTimeline.

If you would like ActivityTimeline to always show tasks based on sprint dates (If sprint is indicated), please, navigate to Configurations → Advanced Settings → Custom Functionality → Paste the following text PRIORITIZE_SPRINT_DATES Click 'Update'.

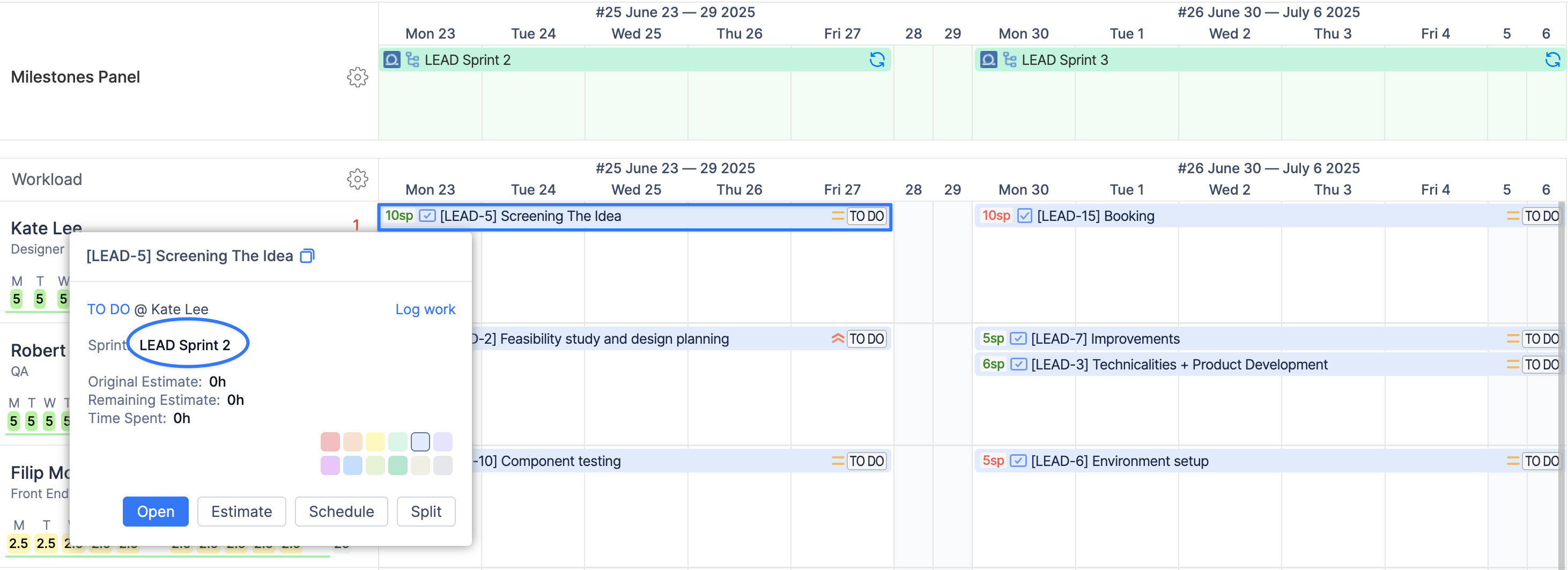

Once enabled when dragging and dropping tasks from the issue panel to a user, or from user to user, the behavior has been updated as follows: initially, the task will be displayed for the dates you dropped it for. However, after clicking "Refresh" at the top right corner, the task will then reflect the dates of the sprint:

CleanShot 2024-09-06 at 17.50.10-20240906-145306.gif

Important:

If PRIORITIZE_SPRINT_DATES isn’t enabled:

  • Do not drag and drop tasks on the Planner if you want them to be shown based on sprint dates. Dragging and dropping tasks will assign specific dates to the tasks, overriding the sprint dates.

  • If you have already assigned dates by dragging and dropping, you can revert to using sprint dates by following these steps:

  1. Click on the task.

  2. Go to Schedule.

  3. Clear the Start/End Date fields.

  4. Click ‘Update’.

  5. Click ‘Refresh’ on the top right corner of the Planner.

By following these steps, the task will be displayed on the timeline based on sprint dates.

Sprint Synchronization

If a task is moved from one sprint to another or the dates of the sprint are changed, you can refresh the sprints and their associated issues using the Milestone panel:

Check the video example here: Video Example: How to use Start/End dates of the Jira Sprint to automatically show tasks in ActivityTimeline?
