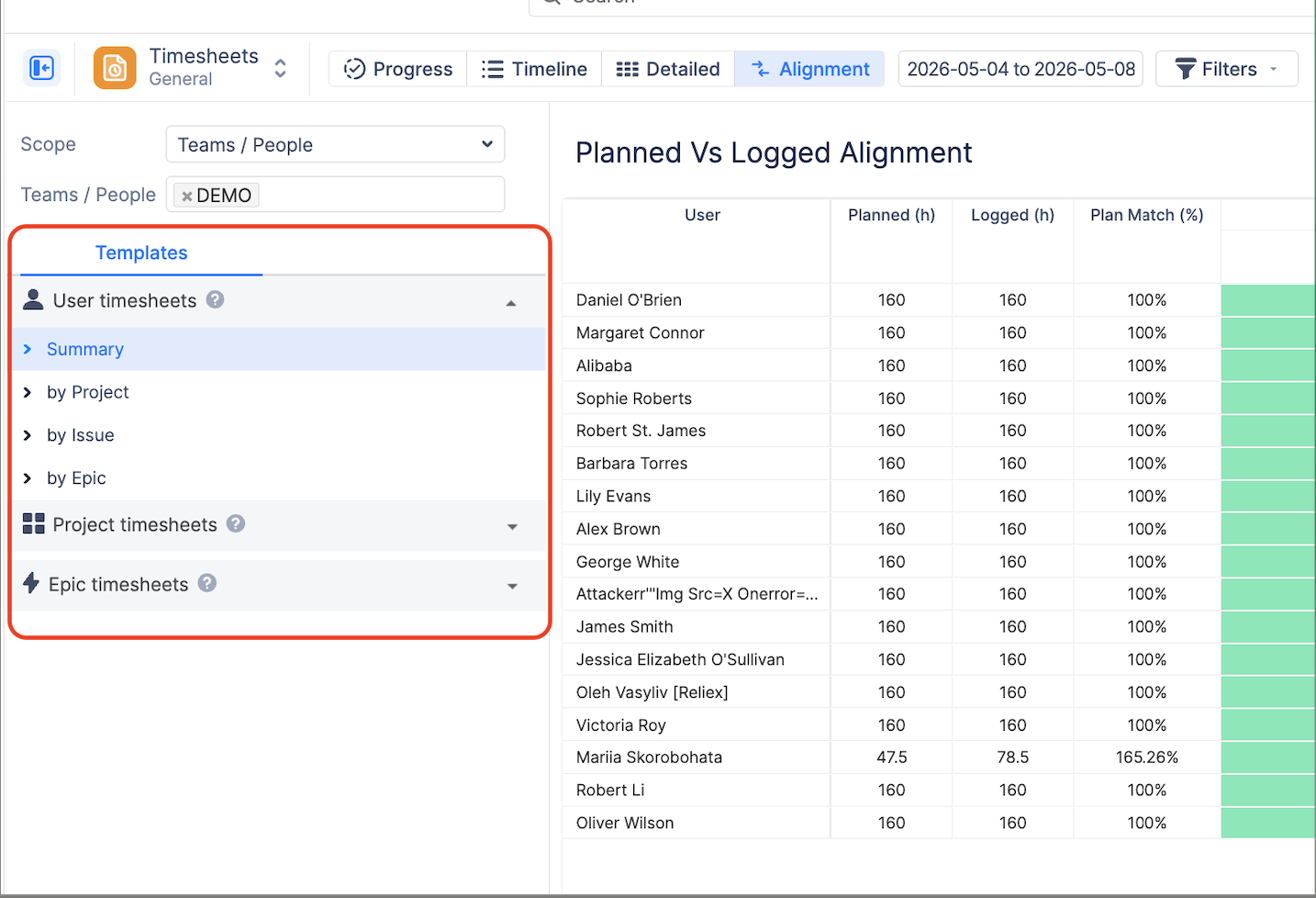

Alignment view is available only to those participating in a closed EAP program.
Contact our support team to join the program.
This view is part of the Advanced Edition of ActivityTimeline.
The Alignment report in Timesheets allows you to compare Planned time vs Logged time over a selected period.
This report helps you understand how accurately the work was executed against the plan by showing:
-
How much time was planned
-
How much time was actually logged
-
the difference (Δ Delta, Hours)
-
the ratio between them (Plan Match, %)
It is useful for managers, team leads, and project managers who want to track whether work is being logged according to expectations.

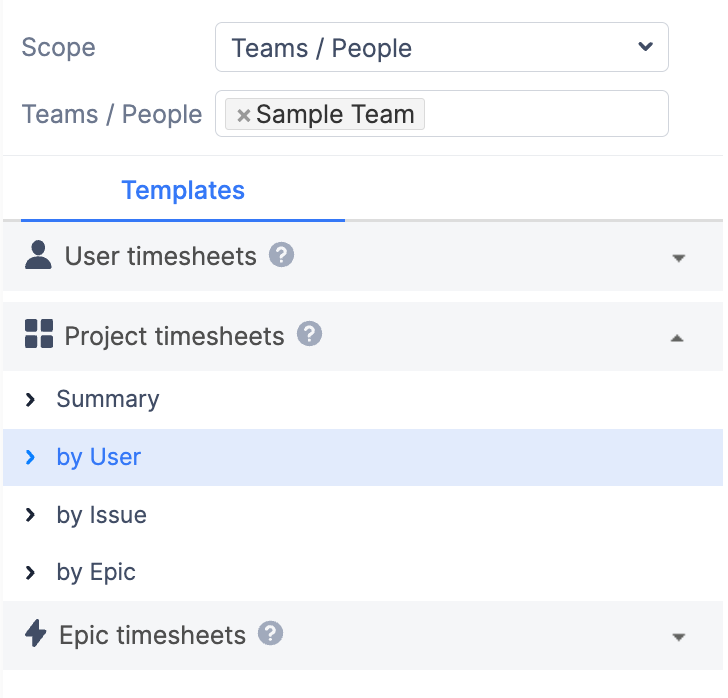

Templates
The report follows the same template structure as Timeline Timesheets.
User Timesheets
-
Summary
-
By Project
-
By Issue
-
By Epic
Project Timesheets
-
Summary
-
By User
-
By Issue
-
By Epic
Epic Timesheets
-
Summary
-
By User
-
By Issue
By default, the report opens in:
User Timesheets → Summary

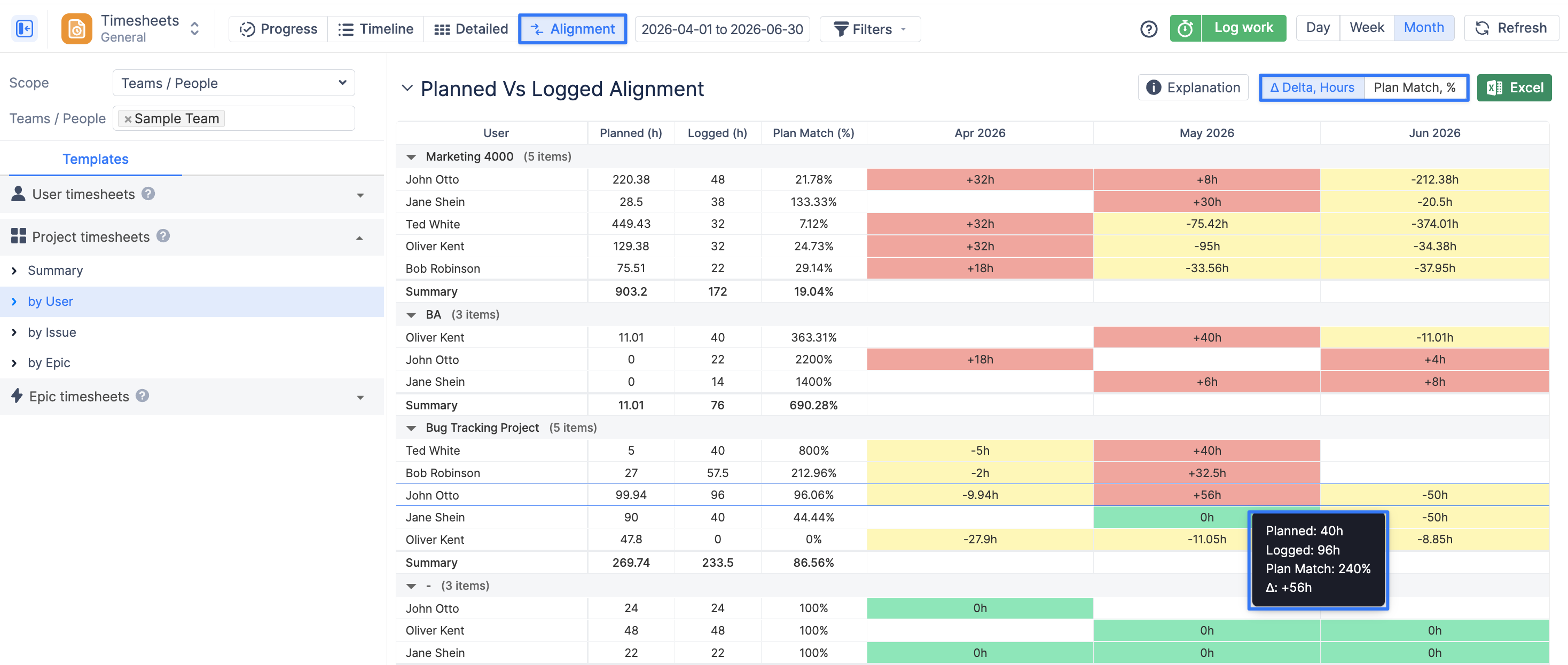

How the report works

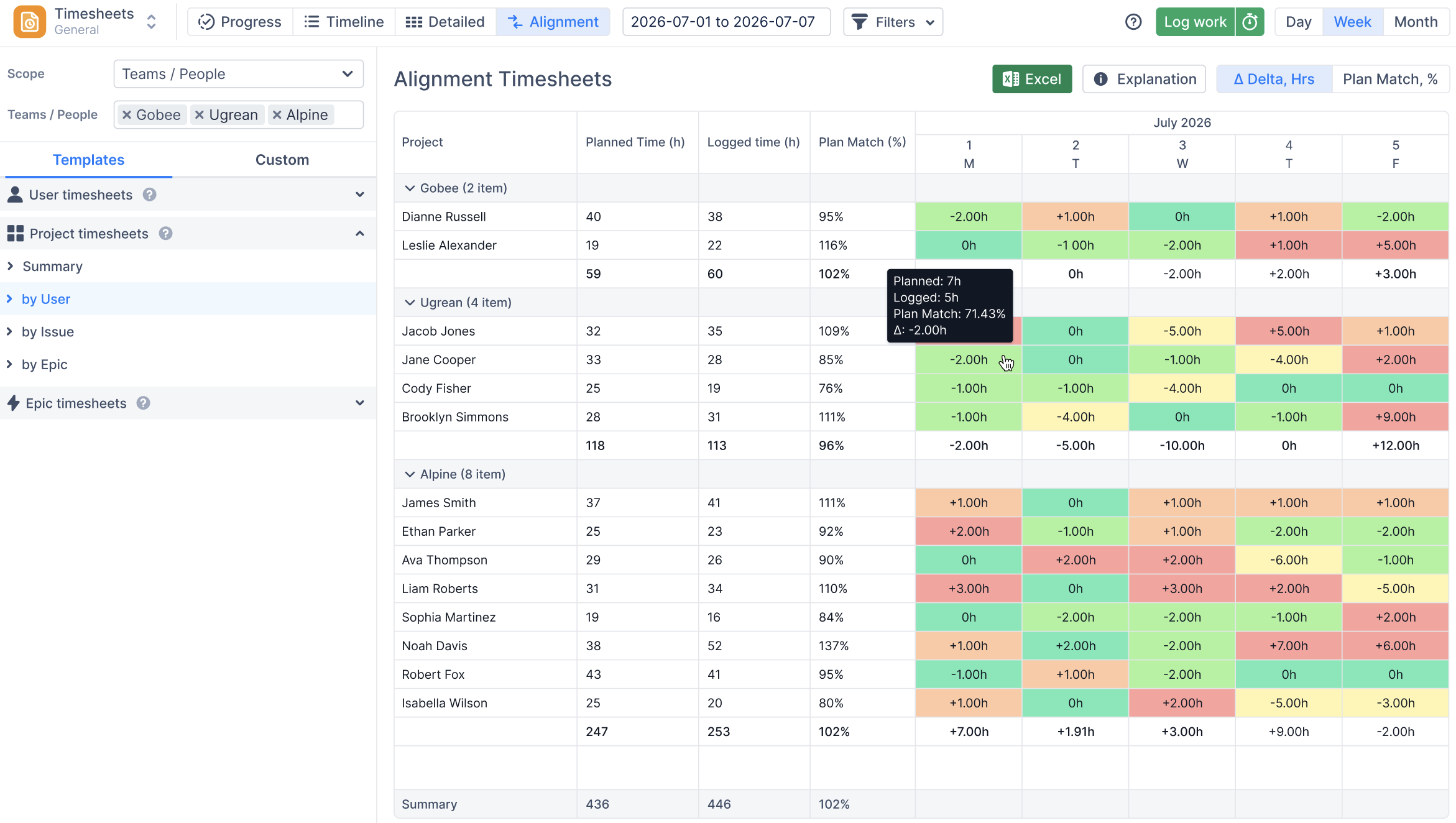

The report compares Planned time and Logged time for each row and period.
Planned time
Planned time is calculated from:
-
Jira issue Original Estimate
-
Bookings
-
Placeholders
It follows the same logic as planning in the Planner.
Logged time
Logged time is calculated from:
-
Jira Worklogs
Optionally:
-

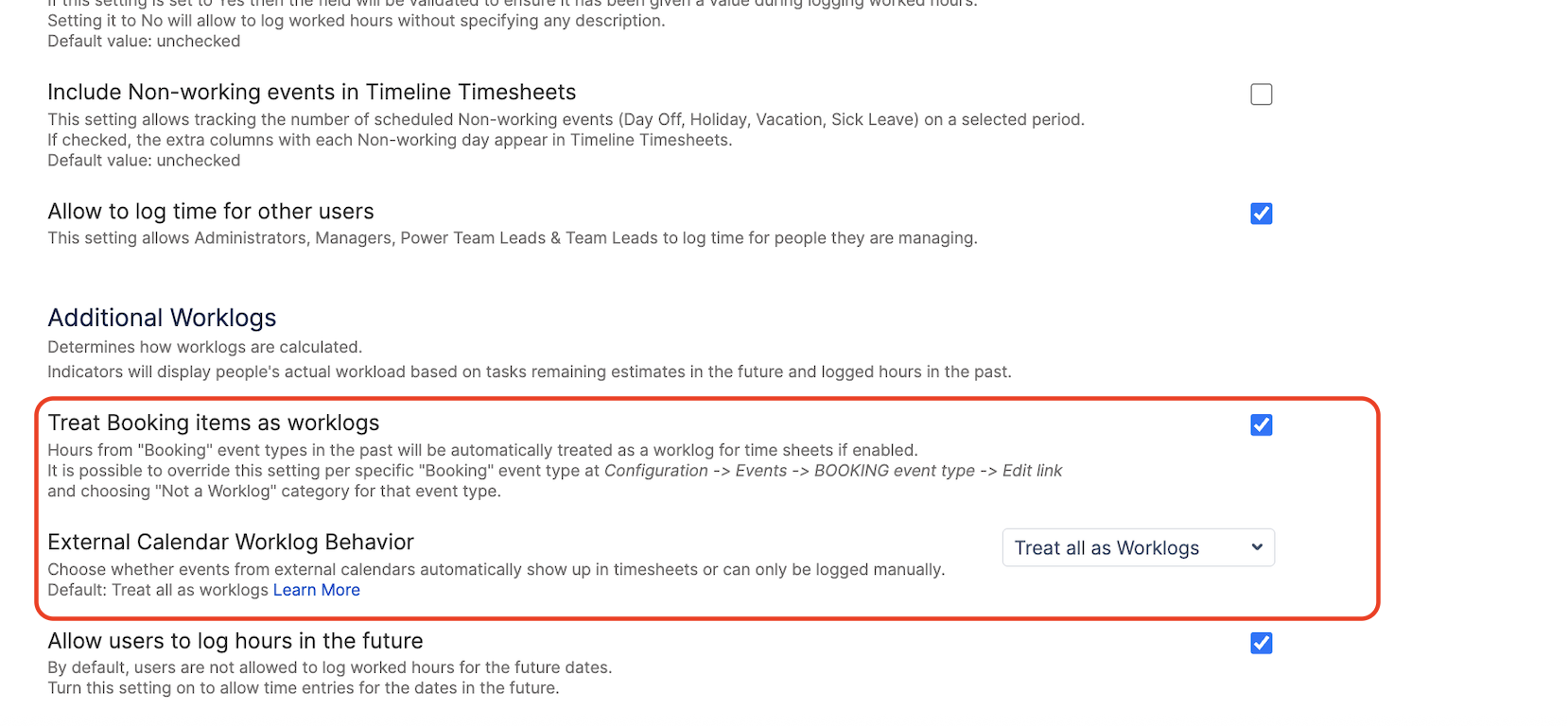

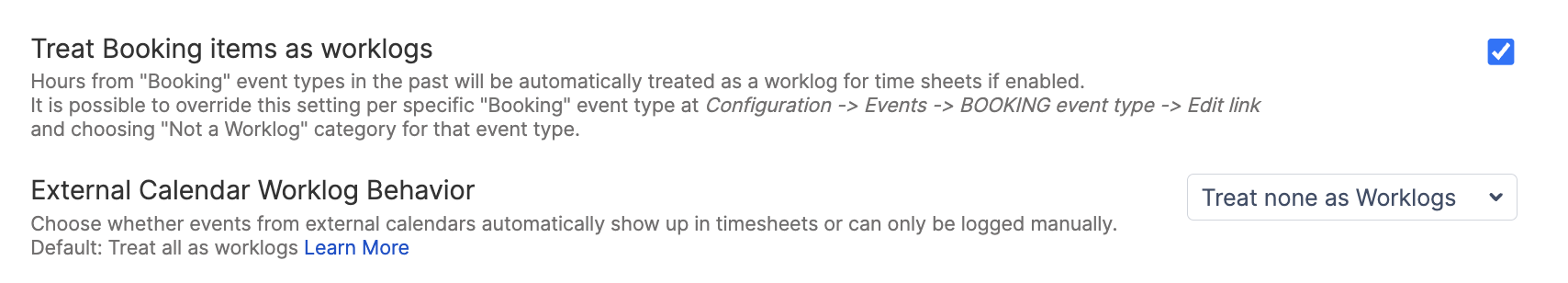

Bookings or Calendar events can be treated as logged time if this setting is enabled:
ActivityTimeline Configuration-> Timesheets Configuration:
Key metrics

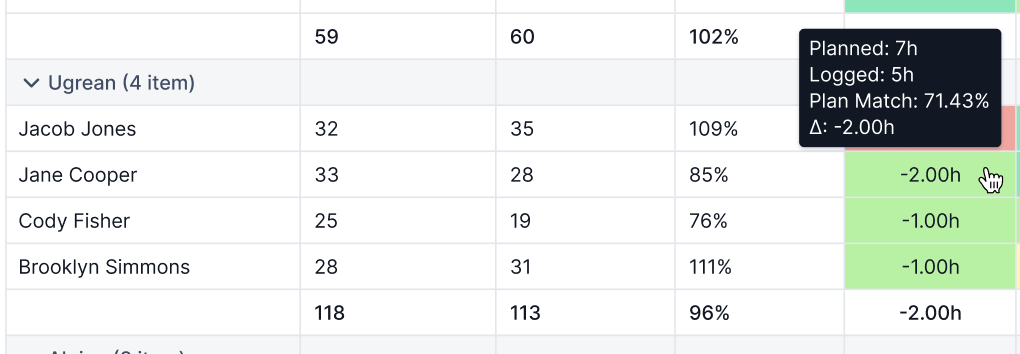

Δ Delta, Hours
This shows the difference between logged and planned time.
Formula:
Δ = Logged time - Planned time
Examples:
-
Planned 40h, Logged 45h → +5h
-
Planned 40h, Logged 38h → -2h
-
Planned 40h, Logged 40h → 0h
Interpretation:
-
Positive (+) → more time logged than planned
-
Negative (-) → less time logged than planned
Plan Match, %
This shows how logged time compares to planned time.
Formula:
Plan Match (%) = (Logged time / Planned time) × 100
Examples:
-
Planned 40h, Logged 40h → 100%
-
Planned 40h, Logged 20h → 50%
-
Planned 40h, Logged 80h → 200%
Important:
-
This is a ratio, not a performance score
-
100% = exact match
-
>100% = more time logged than planned
-
<100% = less time logged than planned

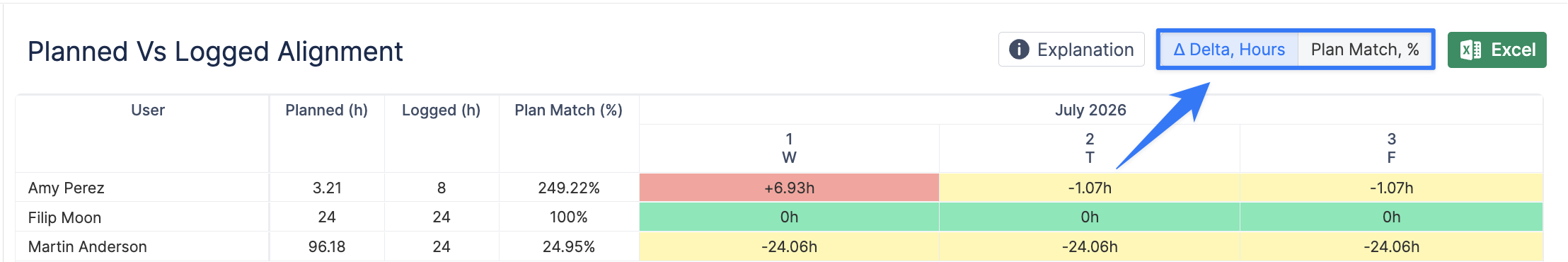

Display modes
The report has two display modes:

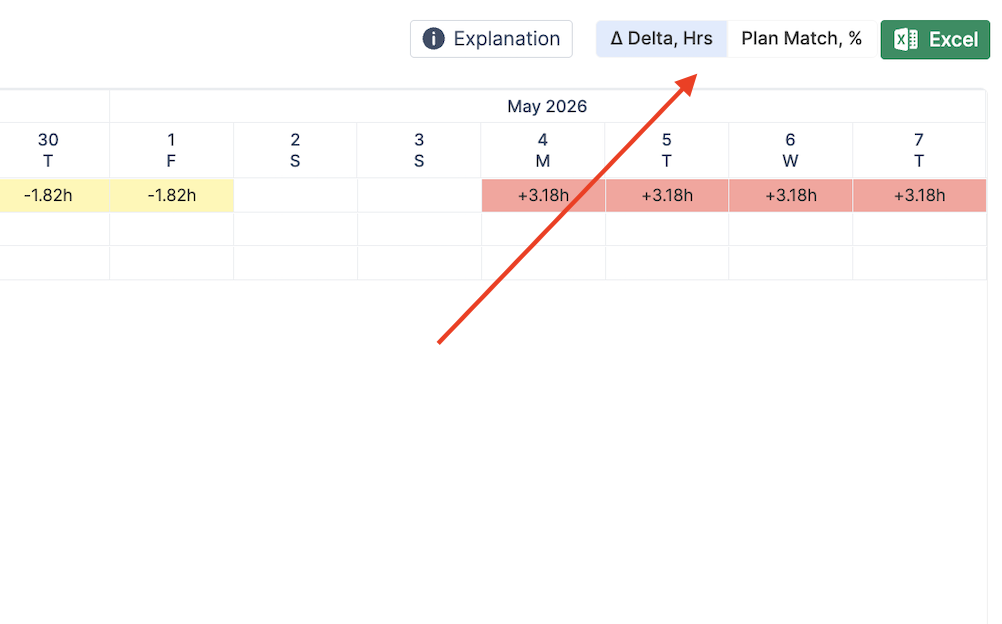

1. Δ Delta, Hours (default)
-
Time buckets show difference in hours
-
Examples:
-
+5h -
-2h -
0h
-
2. Plan Match, %
-
Time buckets show percentage values
-
Cells may include a progress-style fill

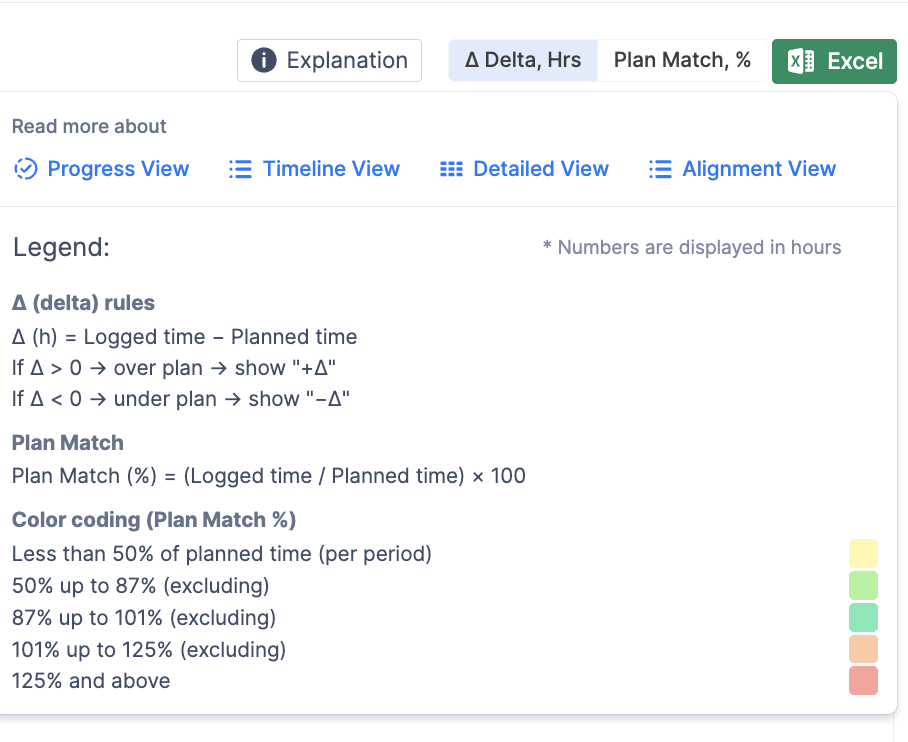

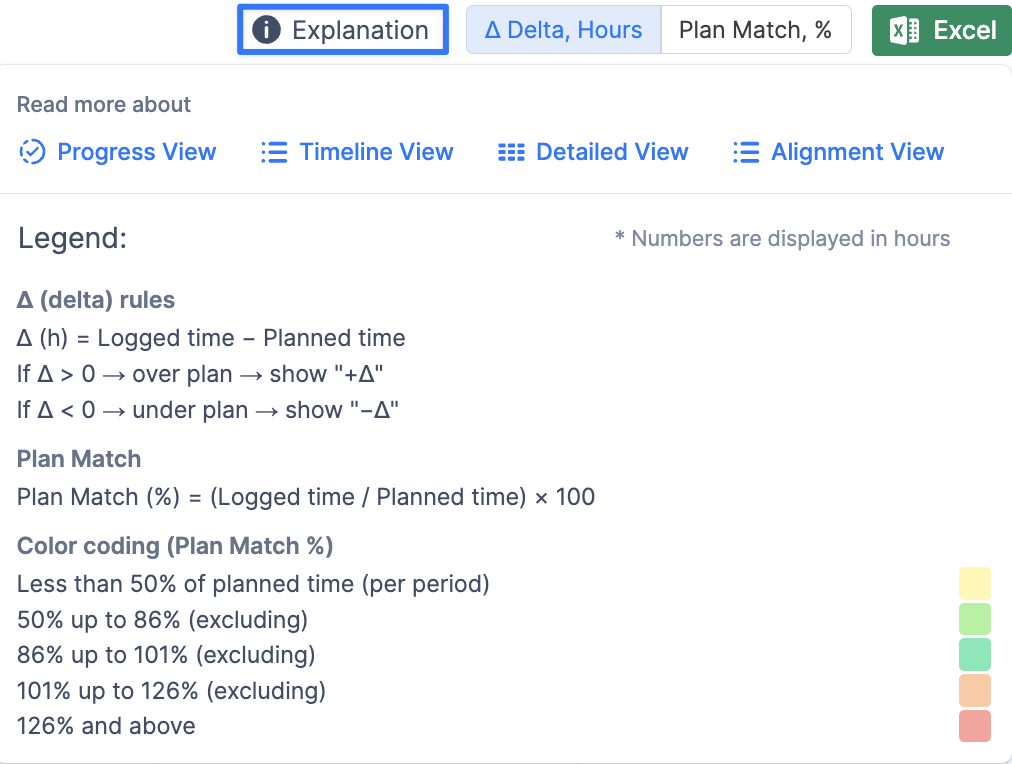

Color coding
Cells are always colored based on Plan Match (%), regardless of the display mode.
Color ranges:
-
< 50% → yellow
-
50% – 87% → light green
-
87% – 101% → green
-
101% – 125% → light red / orange
-
125%+ → red
This allows you to quickly identify:
-
under-logging
-
balanced execution
-
over-logging
Out-of-office, holidays, and weekends
The Alignment report does not adjust calculations based on:
-
days off
-
holidays
-
weekends
The report always compares:
Planned time vs Logged time
Example:
-
Planned: 40h
-
User had 2 days off
-
Logged: 24h
Result:
-
Plan Match = 60%
-
Δ = -16h
Important behavior

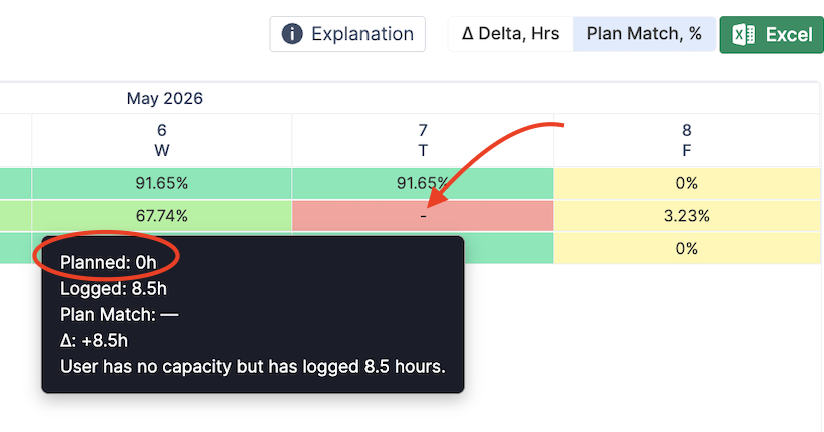

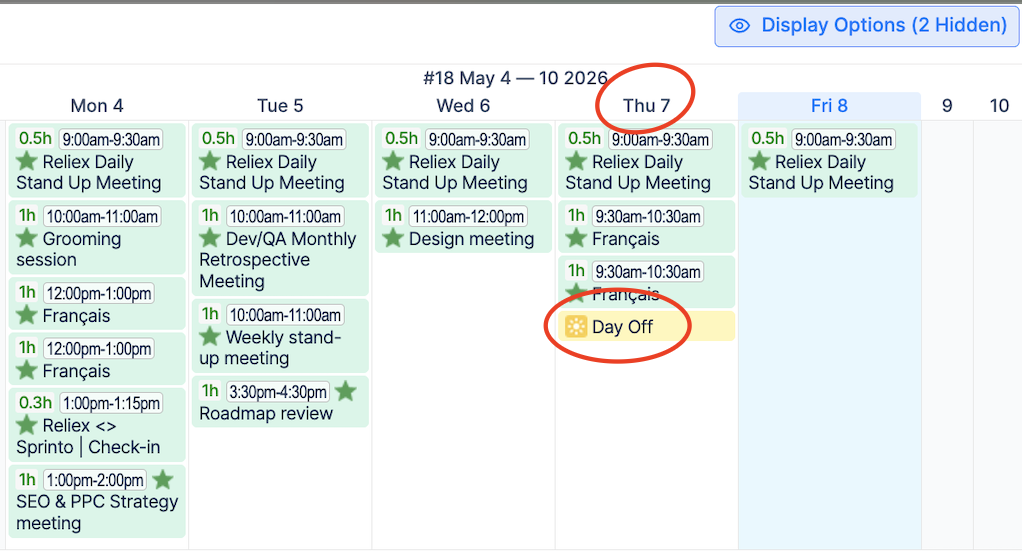

If a user has a day off for the entire period (day/week/month), the system will not calculate planned time for that period.
In such cases:
-
Planned time is treated as 0h
-
Any logged time is considered over logging
Example:
-
Planned: 0h (due to full day/week off)
-
Logged: 8.5h
Result:
-
Δ = +8.5h
-
Plan Match → not applicable

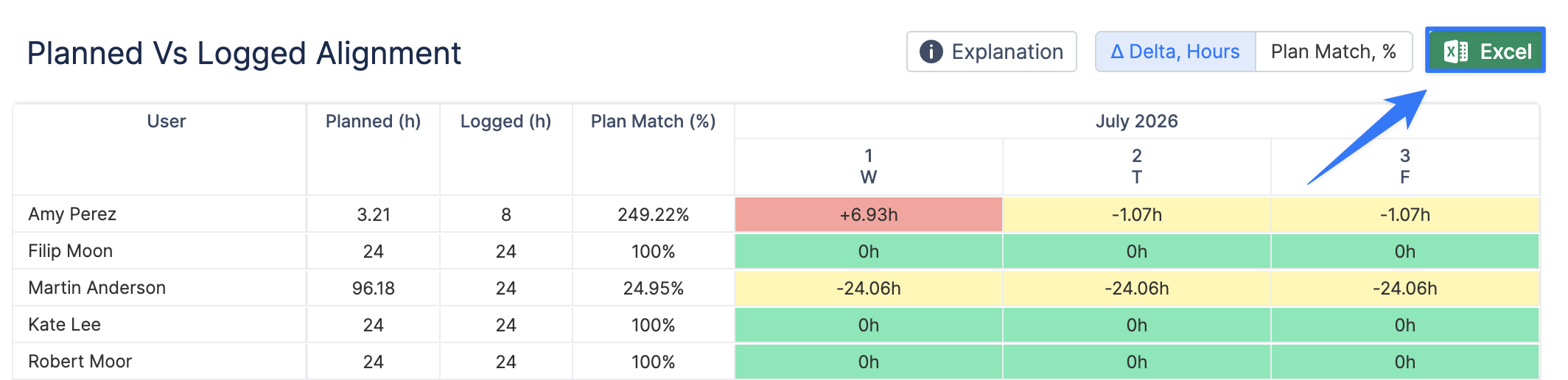

Export

You can export the report using the Excel button.
The export includes the currently visible data:
-
selected template
-
filters
-
grouping
-
time range
FAQ
Why is Plan Match 200%?
Because more time was logged than planned.
Example: Planned 40h, Logged 80h → 200% (2× the planned effort).
Why is my Delta negative?
Because logged time is lower than planned time.
Example: Planned 40h, Logged 30h → Δ = -10h.
No. The Alignment report does not adjust calculations based on non-working days such as:
-
holidays
-
days off
-
weekends
The report always compares:
Planned time vs Logged time
However, there is an important exception:
If a user has no capacity for the entire period (for example, a full day or week off), then:
-
Planned time is treated as 0h
-
Any logged time is considered unplanned (over logging)
Why is the cell colored when I am viewing Delta?
Color is always based on Plan Match (%), even in Δ Delta mode.
Are percentages averaged across rows?
No. The system:
-
sums Planned time
-
sums Logged time
-
then calculates Plan Match from totals.
